Overview
14.58 Km2
Property1
11.5 years
Reserve Life
Copper-Gold
Zinc, Lead & Silver By-products
24 Mlb
Annual Copper Production2
Open Pit
Mine
27 Koz
Annual Gold Production AISC2
Relevant Agreements
An Investment Protection Agreement, executed with the Government of Ecuador, provides El Domo with various benefits until March 2033.
Salazar Joint Venture
Silvercorp owns a 75% stake in Salazar Holdings, whose wholly owned subsidiary, Curimining S.A. (“Curimining”), owns the El Domo project.
Under the joint venture agreement governing El Domo, Silvercorp:
- Funds 100% of the capital costs to production
- Receives 100% of first $30M in free cash flows
- Receives 95% of the free cash flow until all of its investments since October 2017 are repaid, less the Salazar historical investment of $19.8M
Thereafter, project cashflows will be shared 75% Silvercorp & 25% Salazar.
Wheaton Stream
A streaming agreement with Wheaton Precious Metals provides $175.5M in funding available in four installments during construction.
Wheaton is entitled to 50% of payable gold production (until 145,000 ounces are delivered, 33% thereafter) and 75% of payable silver production (until 4,600,000 ounces are delivered, 50% thereafter) in return for payments equal to 18% of the spot prices for the gold and silver delivered, until the value of gold and silver delivered net of the payments is equal to $175,500,000, after which the payment will increase to 22% of the spot prices.
The PMPA covers only the volcanogenic massive sulphide (VMS) potential in the district that can be economically processed at the El Domo mill.
Work History
El Domo is a flat-lying tabular-shaped volcanogenic massive sulphide (VMS) deposit, with mineralization beginning at 30 metres from surface and dimensions of approximately 800 x 400 metres. Approximately 75,000 metres of diamond drilling have been completed on the Curipamba project – mostly centred on El Domo.
Development Plan
| 2026 Technical Report Highlights | |
|---|---|
| Mine Life (excluding construction period) | 11.5 Years |
|
Avg. Annual Payable Production (Years 1 - 11) |
24 Mlb Cu |
| 27 koz Au | |
| 26 Mlb Zn | |
| 529 koz Ag | |
| 0.7 Mlb Pb | |
| Project Economics (After-Tax) | |
| NPV8% | $571M |
| IRR | 46% |
| Payback Period | ~3 Years |

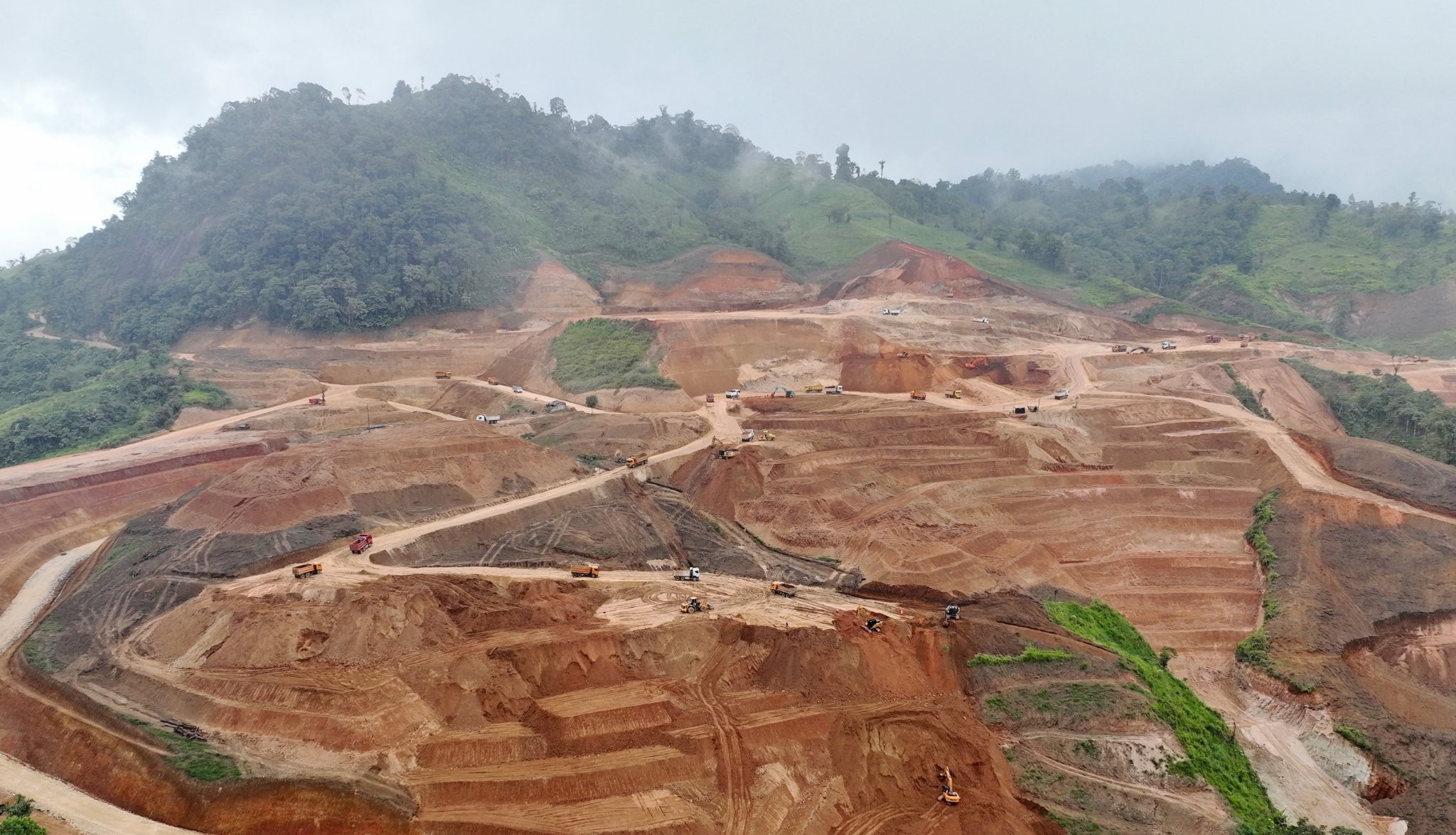

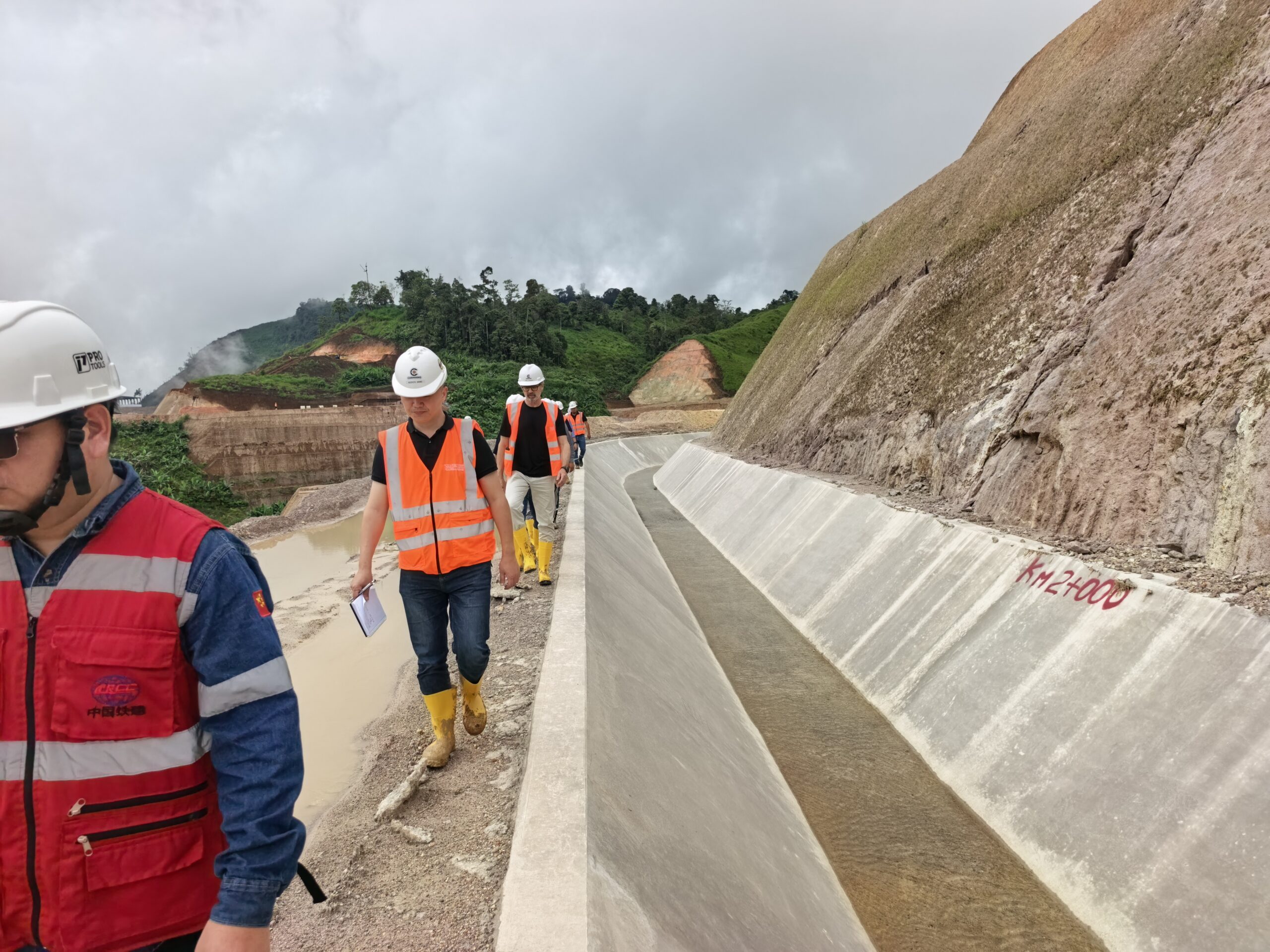

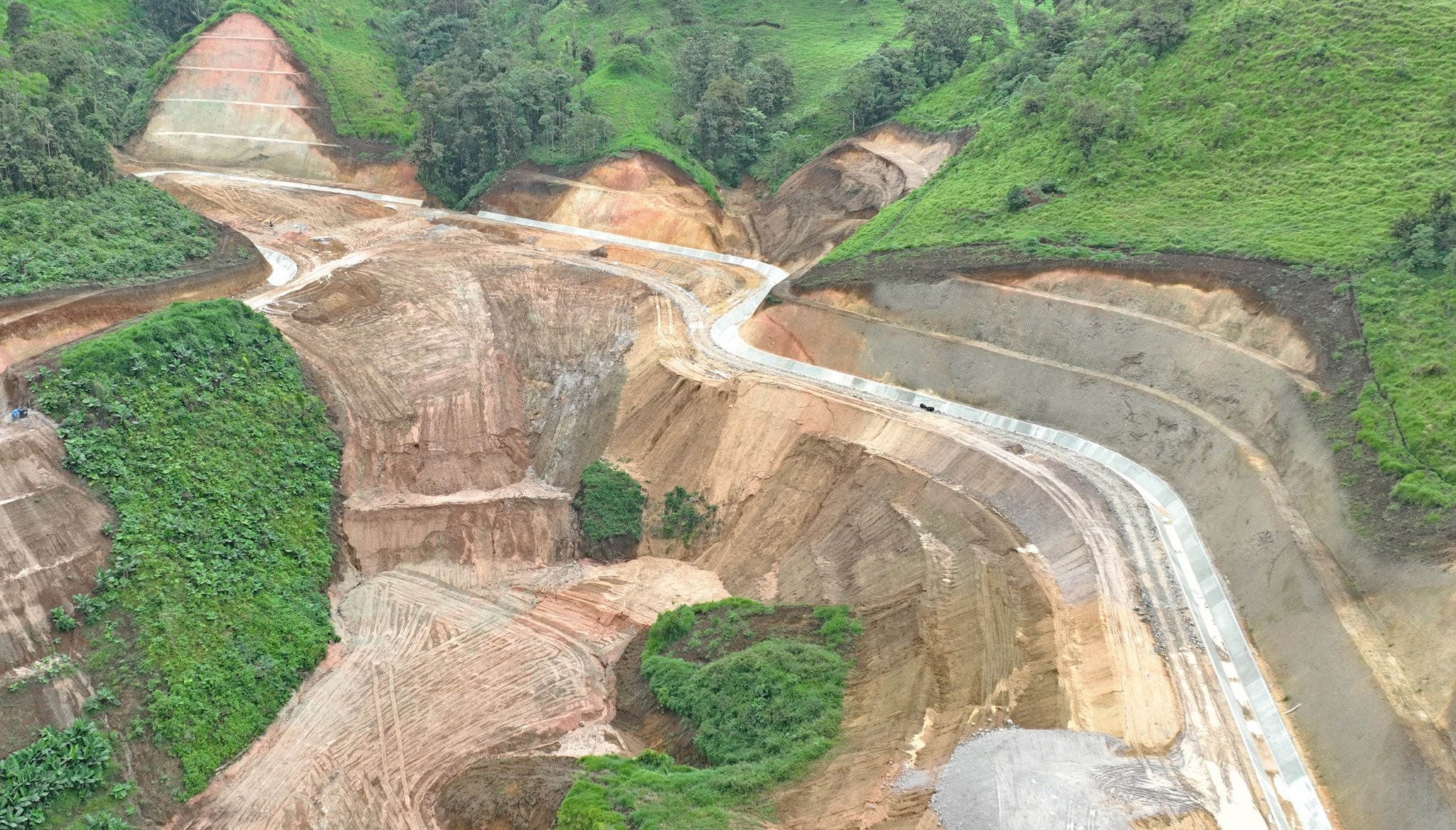

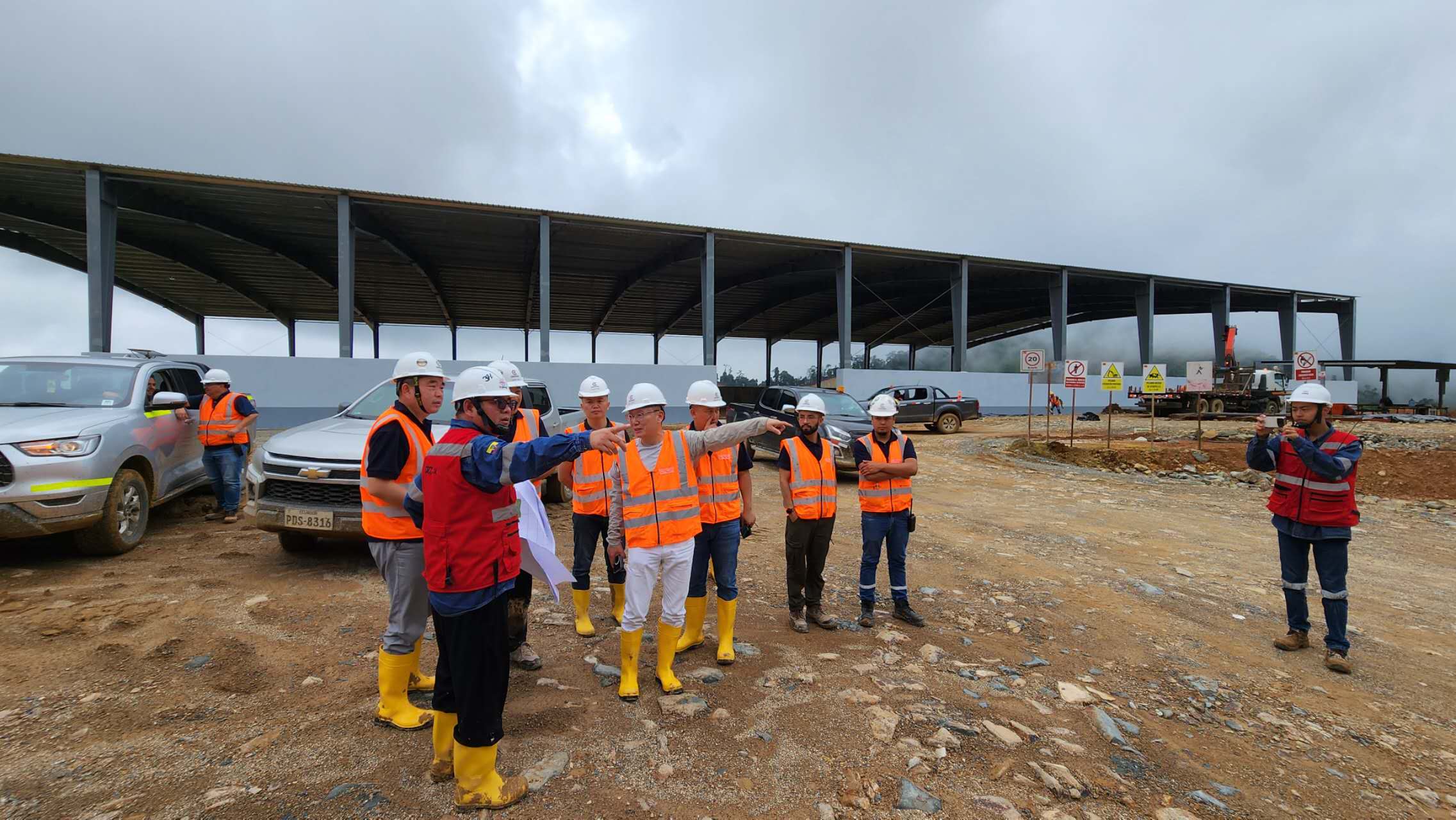

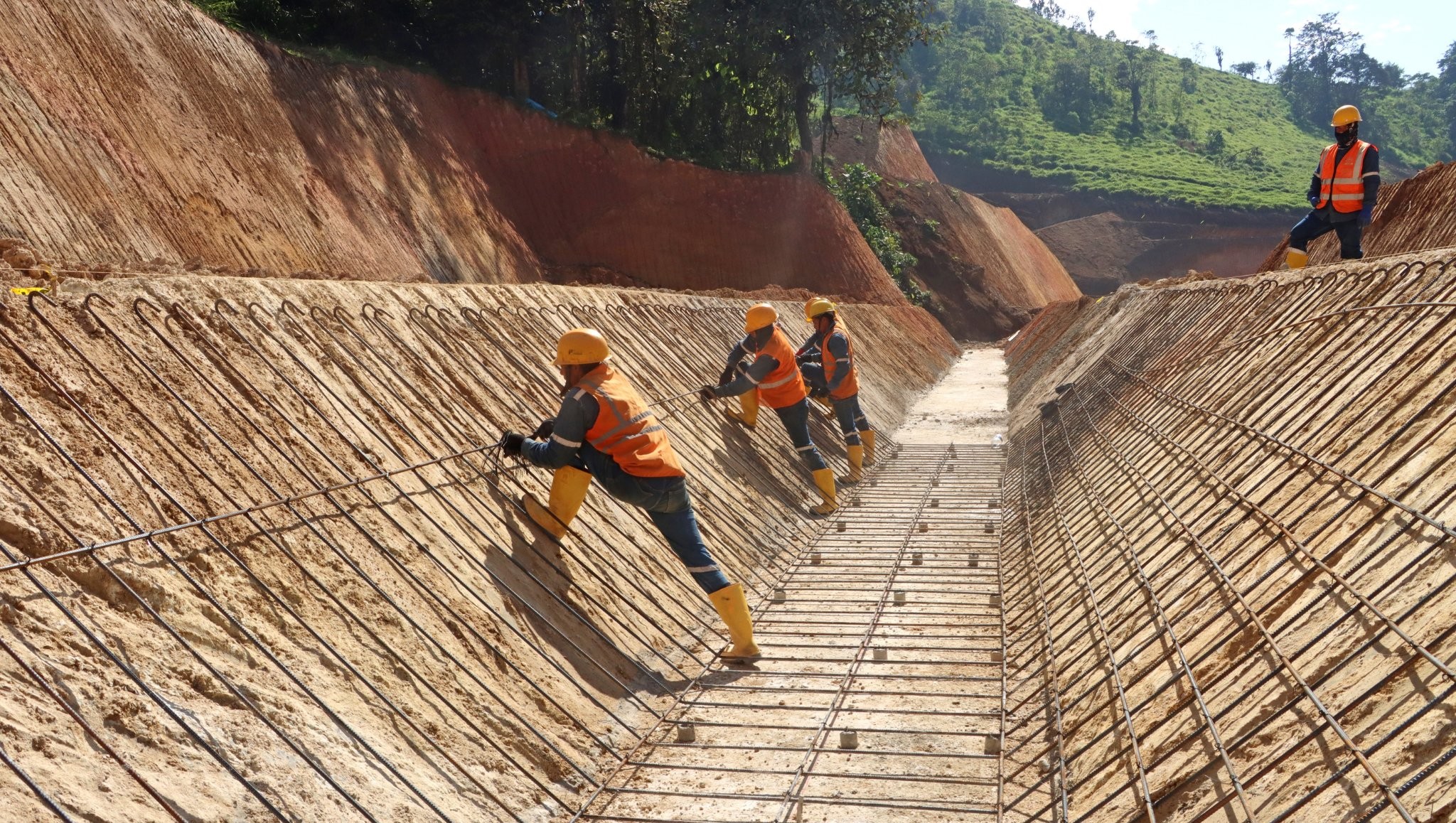

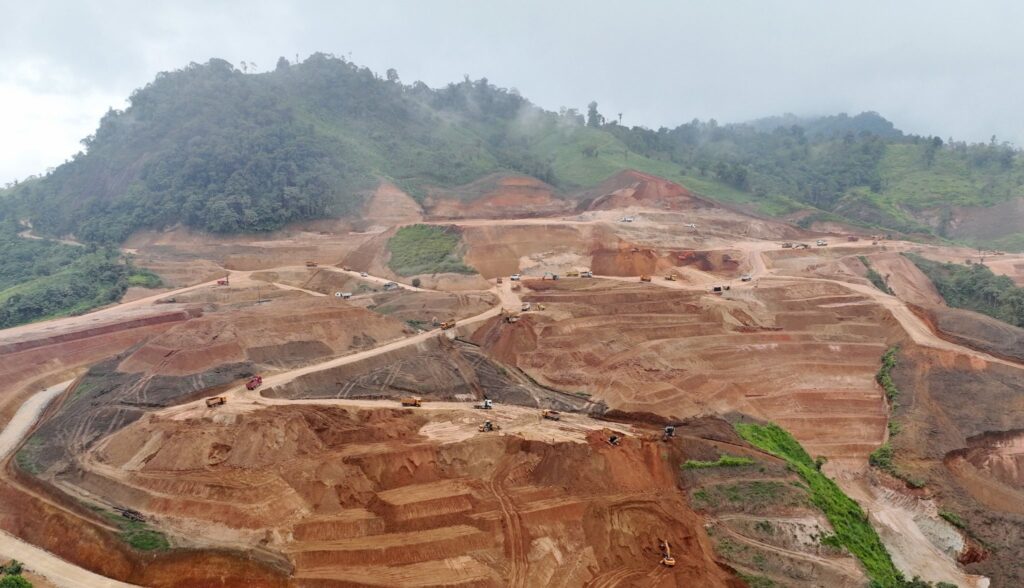

NEW BUDGET CONSTRUCTION STATUS

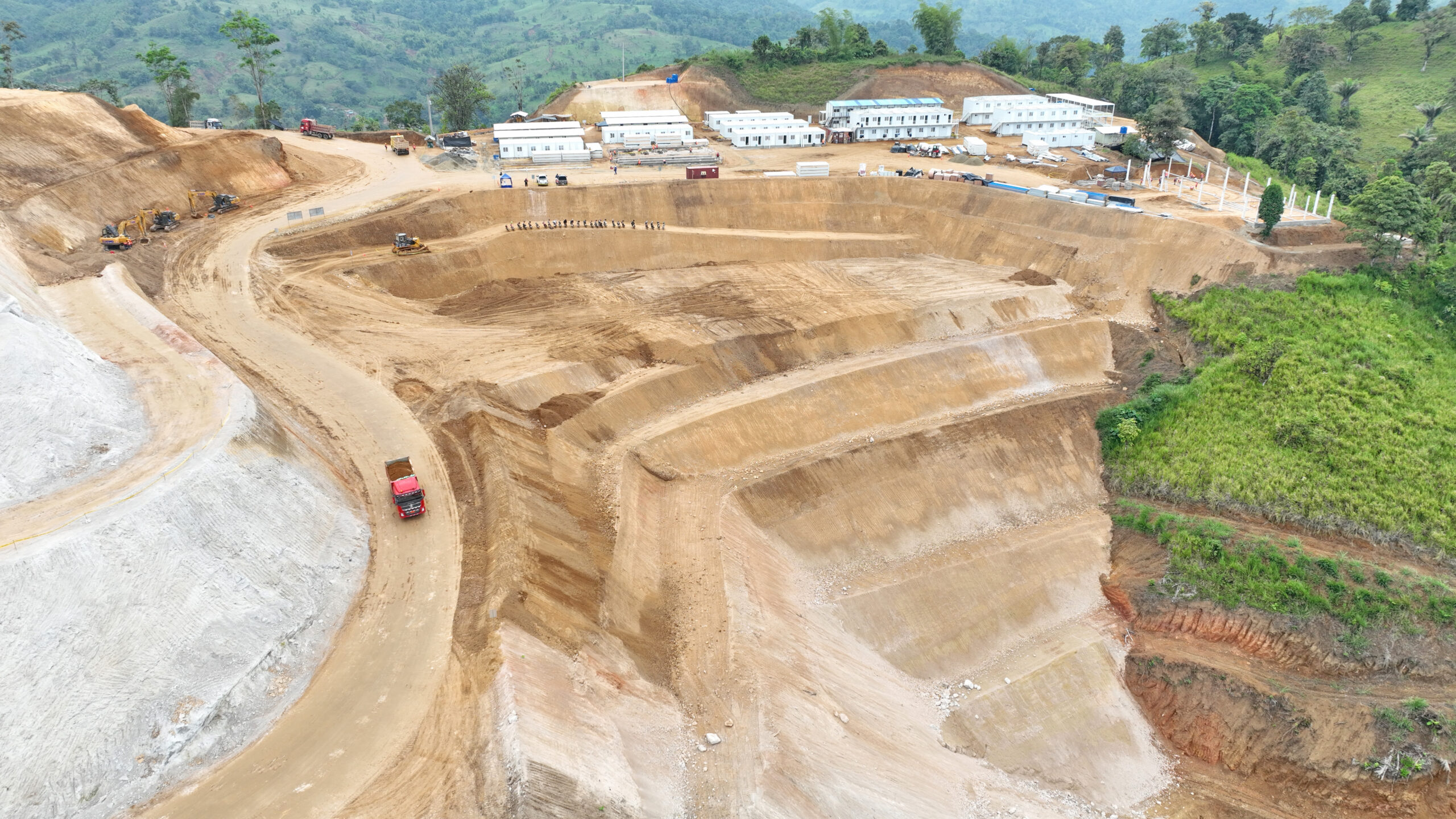

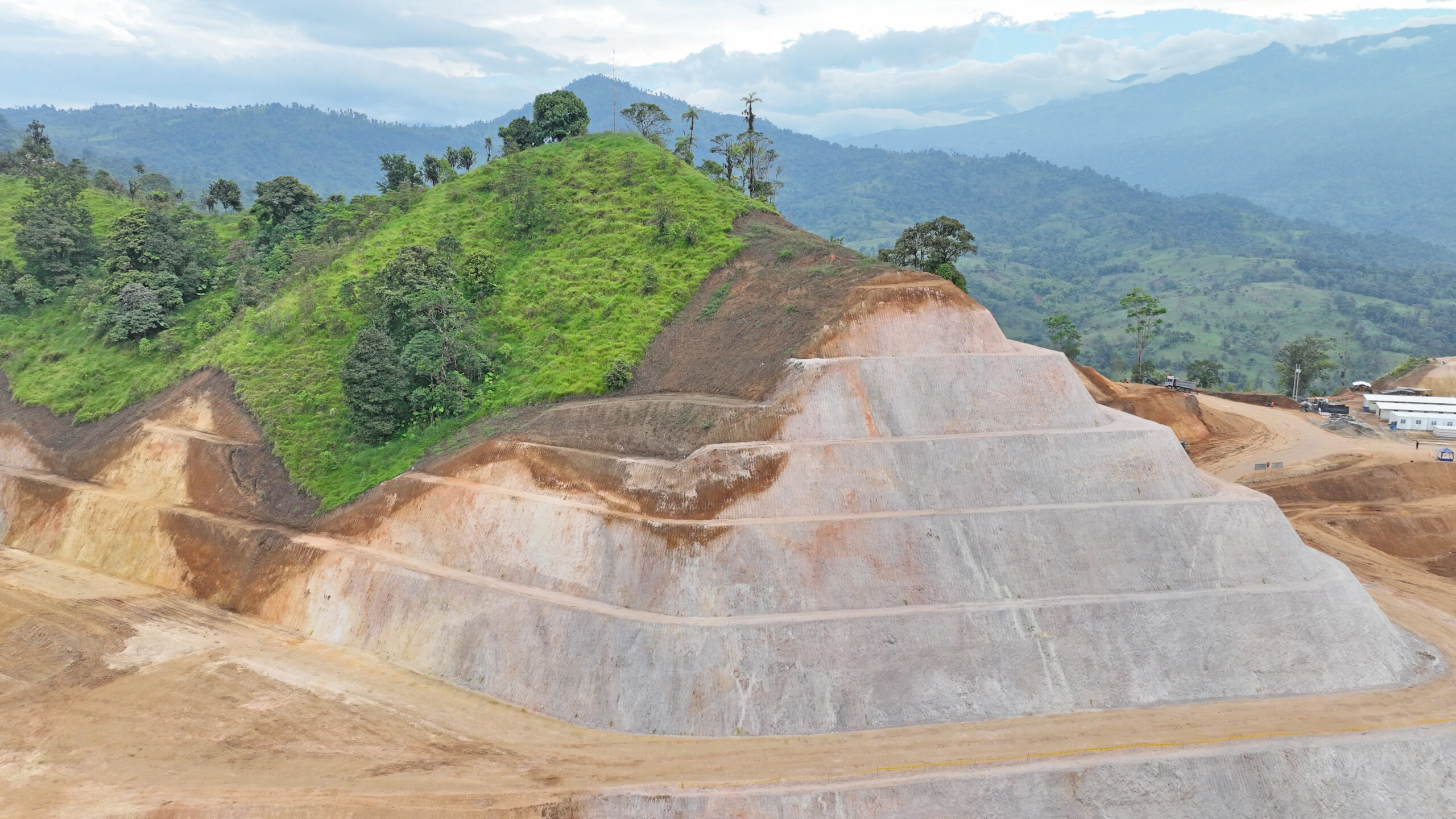

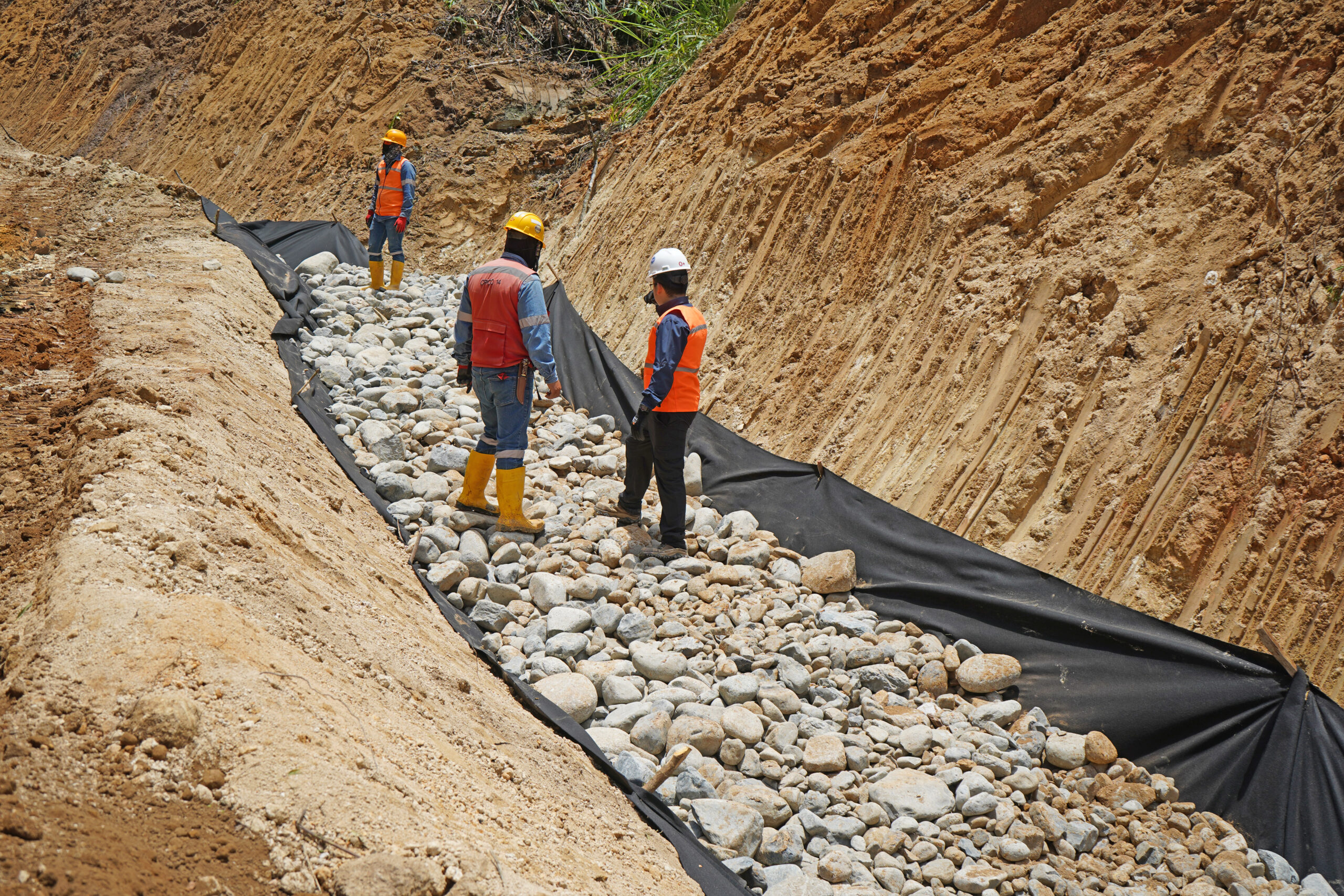

El Domo’s construction capital cost is estimated at US$284 million, of which US$160 million is budgeted in FY2027.
Silvercorp is targeting first production by July 2027.
Curipamba Exploration Potential
The El Domo VMS deposit is located within the larger Curipamba property, which consists of seven concessions covering approximately 215 square kilometres.
Latest News
- Silvercorp Announces Project Update for El Domo – 04 February 2026
- Silvercorp Announces Ecuador Constitutional Court Decision Upholding Environmental License for El Domo Project – 05 August 2025
- Silvercorp Announces the Construction Plan and Schedule for the Development of the El Domo Project – 23 April 2025
Latest Tech Report
- 2026 El Domo NI 43-101 Technical Report – 31 May 2026
